EPS@ISEP | The European Project Semester (EPS) at ISEP
Work plan
Deadlines
2015-03-02 Choose a project proposal and send the result via email to epsatisep@gmail.com
2015-03-11 Define the Tasks (what must be done), Task allocation (who does what) and Gantt chart (when) of the project and insert them on the wiki (planning)
2015-03-27 Specify the list of material (what, quantity, where to buy - local companies are mandatory) on the wiki
2015-04-05 Upload the Interim Report and Presentation to the wiki; the report should contain the Introduction, including the tasks, team members allocation and Gantt chart, State of the Art, Marketing Plan, Project Management, Eco-eficiency Measures for Sustainability, Ethical and Deontological Concerns, Proposed Solution and Bibliography chapters
2015-04-09 Interim Presentation, Discussion and Assessment
2015-06-12 Upload the Final Report, Presentation, Video, Paper, Poster and Manual
2015-06-18 Final Presentation, Individual Discussion and Assessment
2015-06-25:
Update the wiki with all correction suggestions
Hand in a CD with the corrected deliverables (source + PDF) together with all code produced to the EPS coordinator
Hand in one printed exemplar of the corrected report to the EPS coordinator
2015-06-26:
Hand in the prototype and user manual to the client
Receive the EPS@ISEP certificate
Tasks
| Task | Responsible |
| Project Selection | Entire Team |
| Gantt Chart | Imre and Thies |
| Team building Presentation | Entire Team |
| Leaflet | Thies |
| Material Research and Selection | Entire Team |
| State of the Art | Jonny and Marc |
| Marketing | Roberto and Thies |
| Energy and Sustainability | Imre |
| Ethics and Deontology | Gizem |
| Investigation | Entire Team |
| Planning | Entire Team |
| Development | Entire Team |
| Testing | Entire Team |
| Interim Report/Presentation | Entire Team |
| Final Report/Presentation | Entire Team |
| Poster | Marc and Imre |
| Paper | Gizem and Roberto |
| Manual | Entire Team |
| Video | Imre and Jonny |
| Logbook | Entire Team |
| Website | Jonny |

Gantt Chart

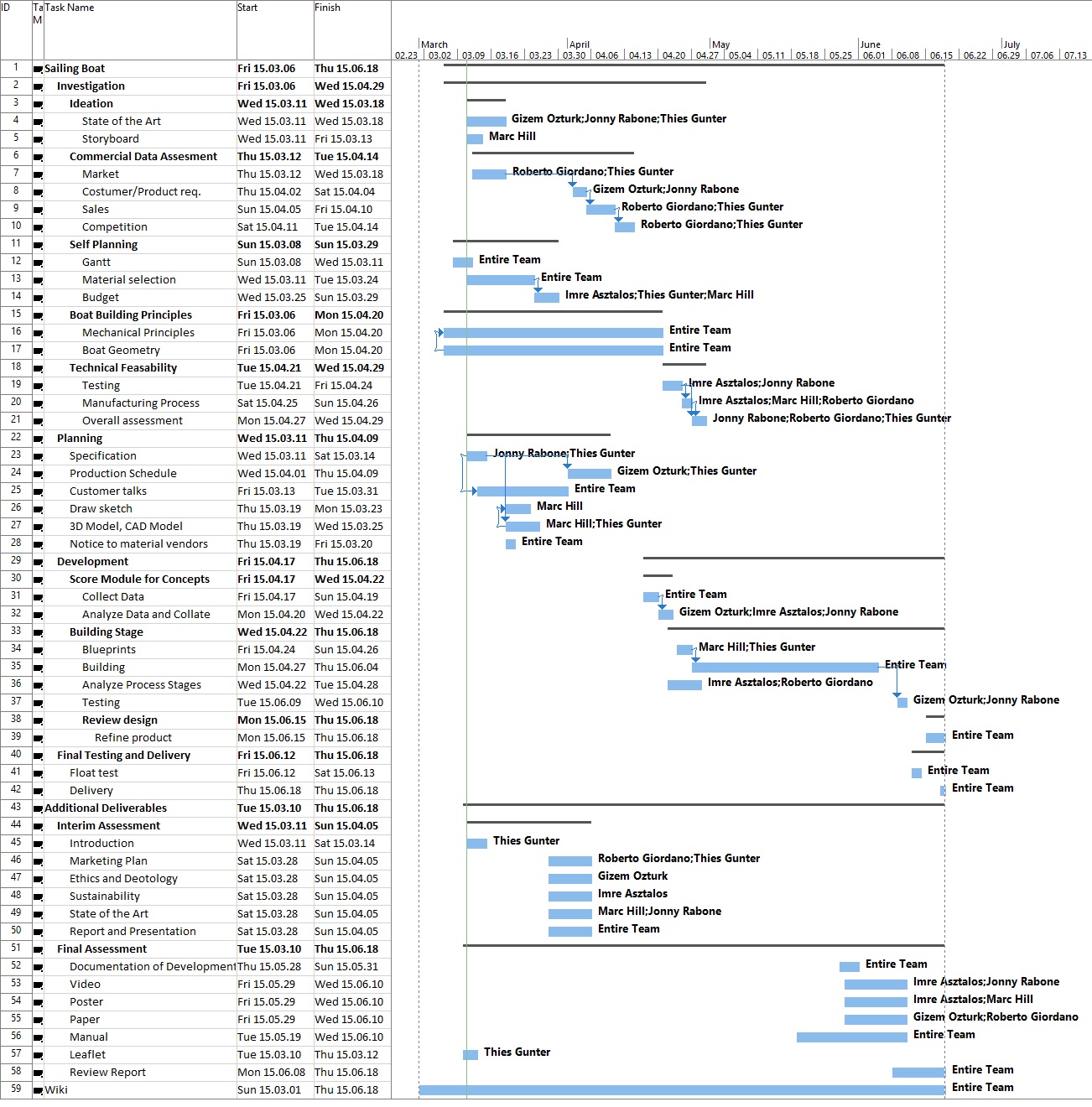

Alternative Gantt Chart
